Track the zoning, permitting, utility, and environmental decisions that can change datacenter feasibility, cost, and timing.
Regulatory Change in Focus
Selected dated case. The assessment reflects the records identified below.
Jurisdiction
Georgia · Georgia Power service territory
Procedural status
Adopted January 23, 2025
Assessment prepared
2026-09-09
Case period
January 2025
Georgia allowed longer power commitments for large new loads
Executive summary
In January 2025, Georgia approved changes to Georgia Power’s service rules intended to keep the cost of adding large new customers from falling on existing customers.[3] The Commission said the rules allow minimum billing requirements and longer contracts, extending from five years to fifteen.[1]
For datacenter developers, those terms can change the economics of a phased build: utility payment commitments may outlast a delayed tenant move-in or a slower-than-planned increase in load. The commercial question is how much power a project must pay for, and for how long—not simply whether a utility has agreed to serve it.
Georgia Public Service Commission, Docket 44280, signed order filed January 28, 2025 · 2025-01-23

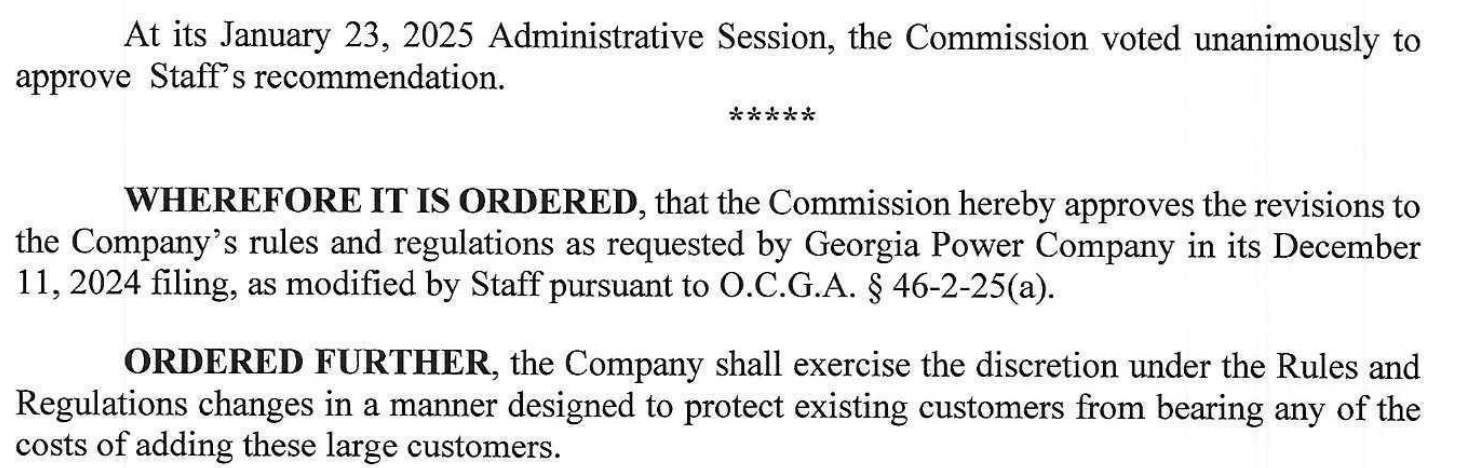

The Commission unanimously approved staff’s recommendation on January 23, 2025, and ordered approval of Georgia Power’s requested rule revisions as modified by staff.[3]
Georgia Public Service Commission, official news release · 2025-01-23

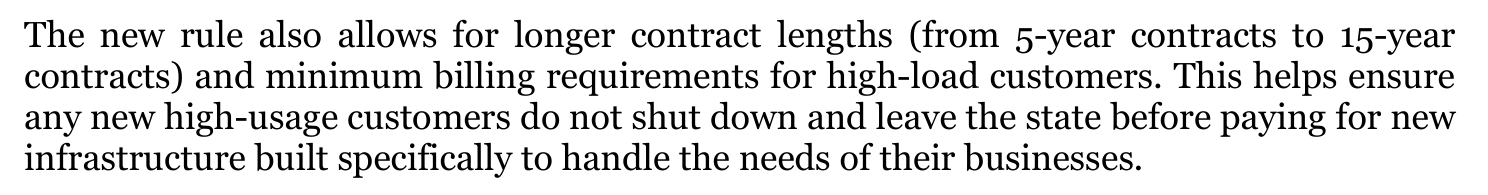

The Commission’s contemporaneous announcement said the new rule allows minimum billing requirements and longer contracts, from five years to fifteen years.[1]
Georgia Public Service Commission, signed order, page 2 · 2025-01-28

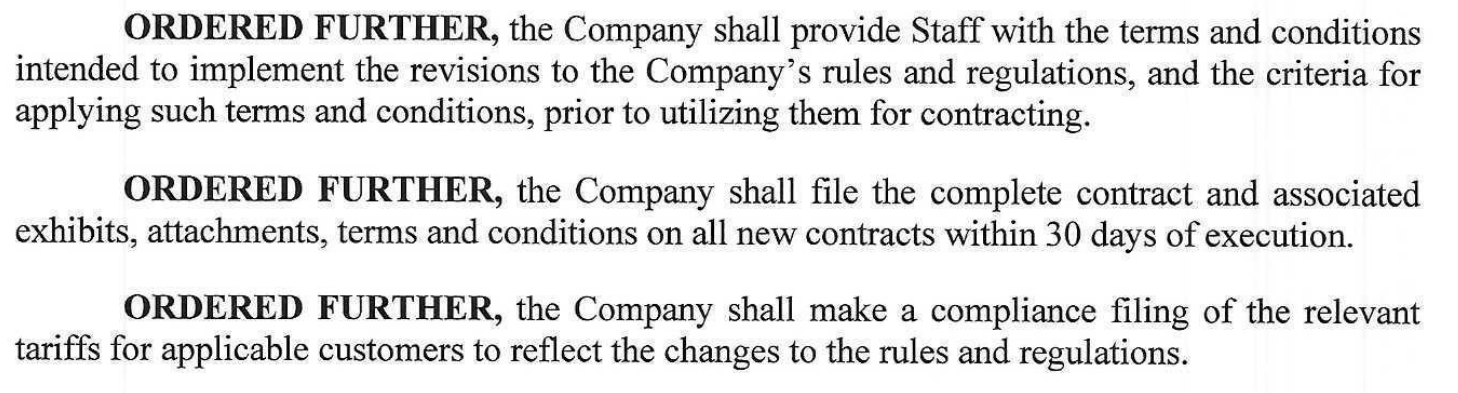

The order requires implementation terms and application criteria to be provided to staff before use in contracting, and a compliance filing of relevant tariffs reflecting the rule changes.[3]
Minimum bills and longer contracts can leave a developer paying for capacity before tenants use it. A financing plan therefore needs to test utility obligations against delayed occupancy, a slower load ramp, and early exit. The rule change alone establishes neither a project’s cost increase nor its energization date.
Watch next
The applicable tariff and later orders determine how the rule applies. Customer-specific minimum bills, contract duration, and treatment of delayed or cancelled load could change the assessment; interconnection and energization milestones remain separate questions.
Scope & relevance
Follow the decisions that affect development feasibility, utility commitments, and project timing. Start with a region, utility territory, or project question.
